When replacing a role/resource with another resource, the remaining availability on role is converting to ETC. Initially the Role has zero ETC , Remaining availability as 2240 and this Role is assigned on 2 assignments on a projects with zero ETC. The ETC after replacing Role with Resource is showing as 4480 which means the remaining availability of role is converted to ETC on each Assignment.
This is happening only with Roles/Resources that are already existing on project team tab.. When we create a new role on the same project the issue doesn't replicate.

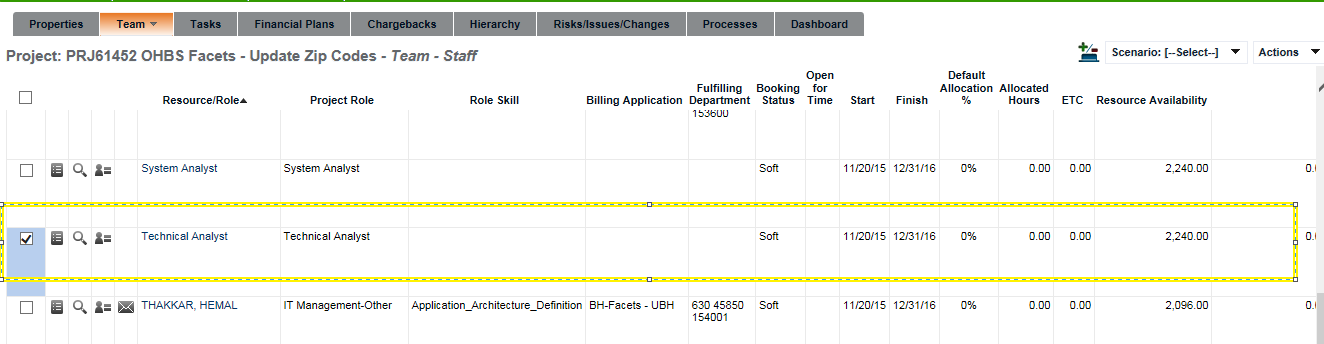

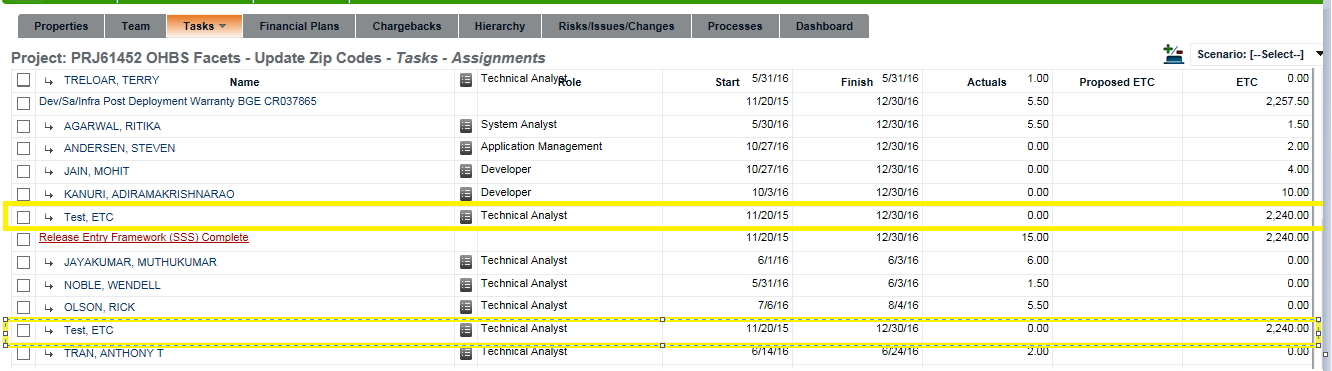

We are on Version 14.2.0.237 05 12. Below are the screenshots of team and task tab before and after replace.
Can some please help with analysis of this issue.
