Sorry - crunched for time. It's best if I bite off small pieces.
About Us: Small, On Premise 14.3 implementation with mature Business Objects environment & reports. Users schedule reports in CA PPM, we run bulk scheduled reports out of Business Objects as well as Report Bursting. Functionally I need to meet these requirements before we can go 'all in' on Jaspersoft. CA PPM with Jaspersoft simply doesn't meet these requirements today. That said, we are seeing incremental enhancements in Jaspersoft Releases and CA has opportunity to build capability as well. Being small and somewhat satisfied with BO - we have the ability to 'sit and wait' in 14.3 with both report servers while hopefully some of these requirements get addressed and I get time to build solutions.
Examples:
Integrate Jaspersoft reports in CA PPM
Automated removal of reports saved by users in Jaspersoft after X days
Hierarchical OBS Browse Input Control in Jaspersoft (Advanced Reporting)
I don't want to implement something that is simply working around a limitation and adds upgradability challenges.
As I understand it, copying reports is working around the limitation of users not being able to easily save parameters & schedules that are their user in scope - like we're accustomed to in the old reports interface?
As I understand it, copying reports creates a new instance of the report breaking the ability for a user to automagically get fixes & enhancements to reports?

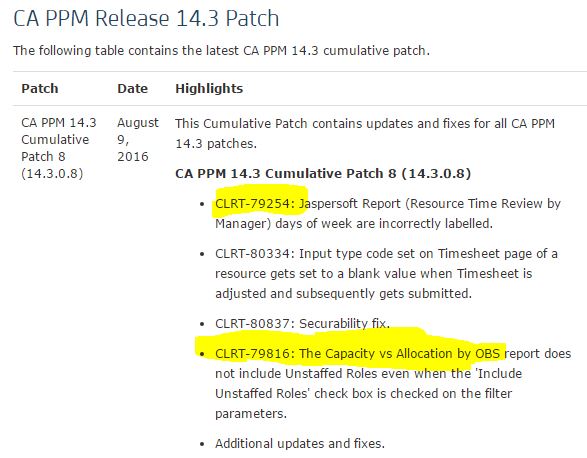

The last 14.3 fixpack had two report fixes:

I don't feel reports are stable enough yet (as shown above), and CA/Jaspersoft are still working the limitations. If you were on the Rego Jaspersoft 6.2.1 webinar the other day - here's the new Master Schedule interface in Jaspersoft 6.2.

Smart people know the business problems to solve. Above demonstrates that good smart people are working them and I hope & trust they keep working them. We have the luxury of waiting this out a bit, therefore I am not encouraging/architecting for copying reports at this time. Valuing upgradability we are encouraging & training scheduling reports with parameters. We hope this will allow us to upgrade both Jaspersoft and the report content as fixes & enhancements come out without breaking the user's schedules.
I'll get to my permissions setup next week.
Again, not saying this is right - this is simply the decision we've made that seems 'good enough' for us for now while we wait for the Jaspersoft solution to mature a bit more and see what shakes out. Not being CA's own tool I understand their challenges here as well. If I was a leader at an Enterprise Software company with no in house BI offerings and a history of buying my way into new markets - this would interest me.
HTH.
